Koroit township renewal - Stage 3

Share Koroit township renewal - Stage 3 on Facebook Share Koroit township renewal - Stage 3 on X (formerly Twitter) Share Koroit township renewal - Stage 3 on Linkedin Email Koroit township renewal - Stage 3 link

Works are now underway on Stage 3 of the Koroit Township Renewal project, following the completion of Stages 1 and 2.

Previous works stages consisted of new footpath, street furniture, drainage and general landscaping works completed on the northern side of Commercial Road between Station Street and Woolsthorpe Road.

Stage 3 works incorporate aesthetic and functional improvements to streetscapes and infrastructure in Commercial Road and High Street, Koroit.

Works in Commercial Road will be completed between High Street (Mickey Bourke's) and Commercial Place (Koroit Theatre).
Works will include:

  • Installation of new footpath
  • Construction of new driveways
  • Installation of new street furniture
  • Minor drainage works

Works in High Street will cover Commercial Road to Horne Avenue and include:

  • Drainage network upgrades
  • Installation of new concrete footpath
  • Road levelling, resealing and asphalting
  • Replacement of any existing street furniture
  • Replacement of current street trees
  • Provision of two new public bus stops close to the senior citizens and library and the northern end of High Street
  • Provision of a new school crossing at King Street

The project is being funding through a $2 million grant from the Federal Government’s Growing Regions program and matching funding from Moyne Shire Council.

Previous Township renewal project information

Engage Moyne Privacy Collection Notice

Works are now underway on Stage 3 of the Koroit Township Renewal project, following the completion of Stages 1 and 2.

Previous works stages consisted of new footpath, street furniture, drainage and general landscaping works completed on the northern side of Commercial Road between Station Street and Woolsthorpe Road.

Stage 3 works incorporate aesthetic and functional improvements to streetscapes and infrastructure in Commercial Road and High Street, Koroit.

Works in Commercial Road will be completed between High Street (Mickey Bourke's) and Commercial Place (Koroit Theatre).
Works will include:

  • Installation of new footpath
  • Construction of new driveways
  • Installation of new street furniture
  • Minor drainage works

Works in High Street will cover Commercial Road to Horne Avenue and include:

  • Drainage network upgrades
  • Installation of new concrete footpath
  • Road levelling, resealing and asphalting
  • Replacement of any existing street furniture
  • Replacement of current street trees
  • Provision of two new public bus stops close to the senior citizens and library and the northern end of High Street
  • Provision of a new school crossing at King Street

The project is being funding through a $2 million grant from the Federal Government’s Growing Regions program and matching funding from Moyne Shire Council.

Previous Township renewal project information

Engage Moyne Privacy Collection Notice

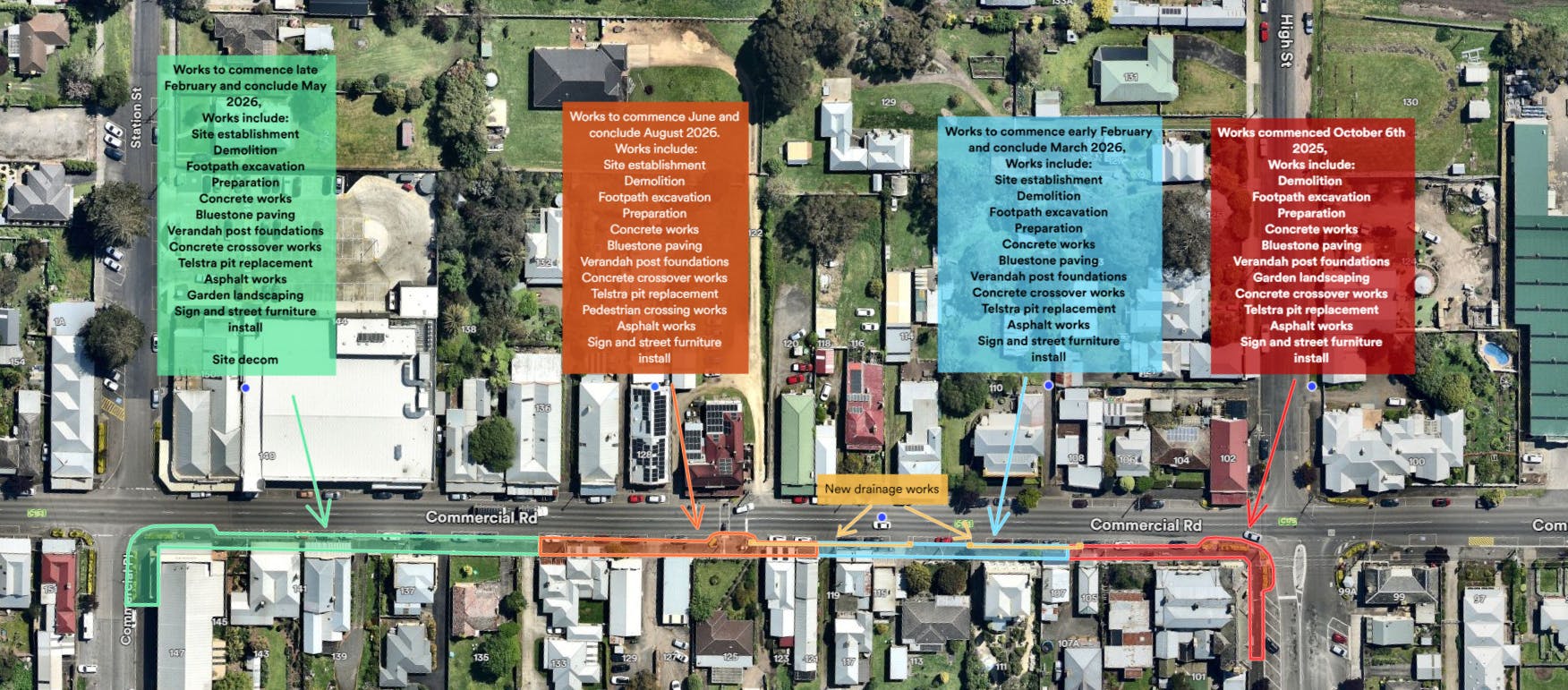

  • Works update 1 October 2026

    Share Works update 1 October 2026 on Facebook Share Works update 1 October 2026 on X (formerly Twitter) Share Works update 1 October 2026 on Linkedin Email Works update 1 October 2026 link

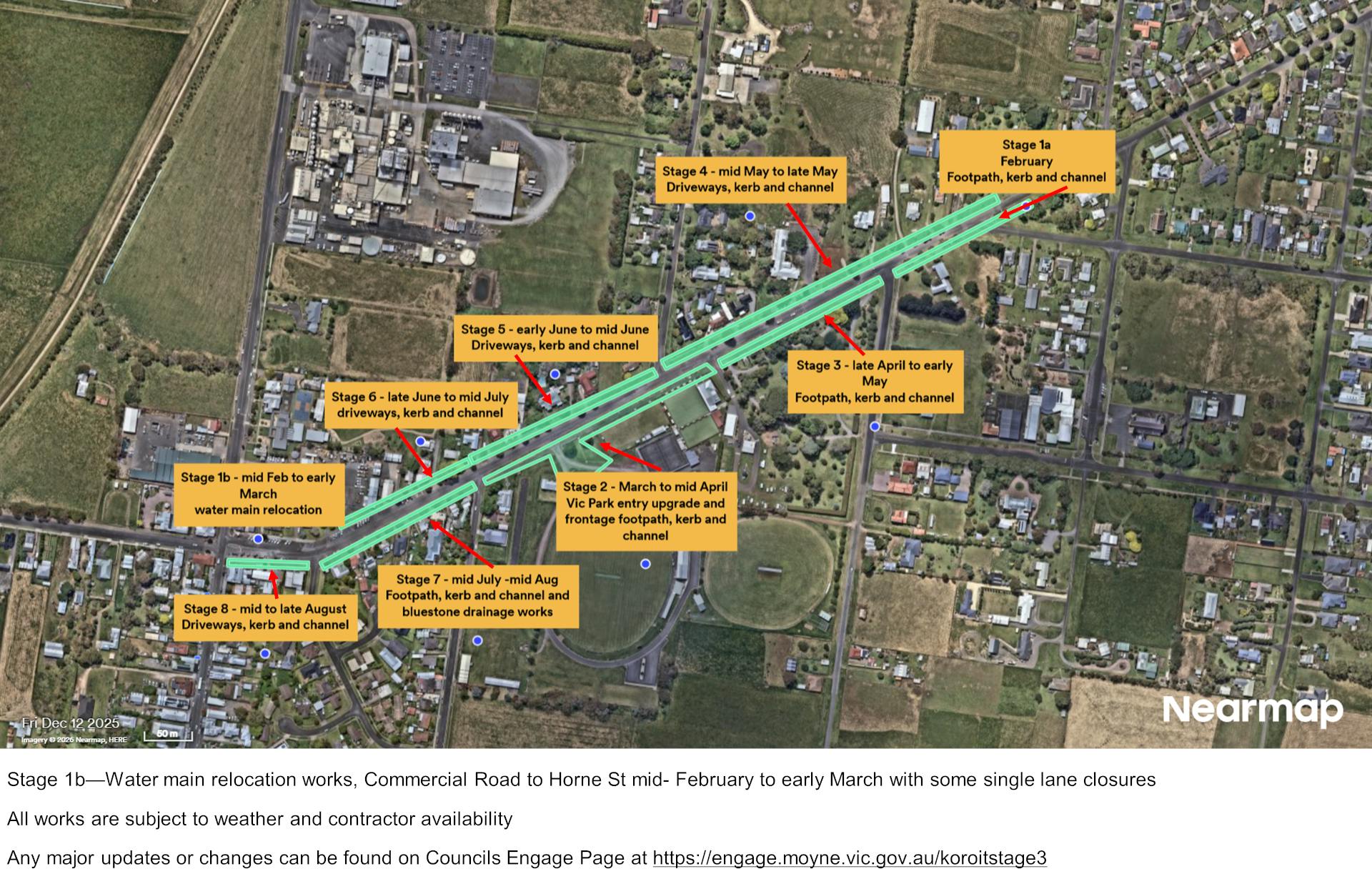

    Streetscape and road improvement works will be undertaken along High Street, Koroit between Horne Street and Commercial Road. This stage of the project has been divided into three construction sections to minimise disruption and allow works to be completed efficiently.

    Construction Sections

    Works are scheduled to occur in October and November 2026, subject to weather conditions and contractor availability, between 7am to 6pm Monday to Friday, with the possibility of some weekend work. Estimated construction dates for each section are:

    Section A: Horne Street to Mill Street - 5 October to 6 November 2026
    Section B: Mill Street to King Street - 5 October to 6 November 2026
    Section C: King Street to Commercial Road - 19 October to 27 November 2026

    Important Information for Residents and Businesses

    During construction working hours, the following traffic and access arrangements will apply:

    • Sections of High Street will be closed to through traffic while roadworks are being undertaken, with detour routes to be signposted.
    • Access for local residents, businesses, deliveries and emergency services will be maintained wherever practical.
    • On-street parking will not be permitted within active work zones during construction activities.
    • Traffic management, detours and reduced speed limits will be in place to ensure the safety of workers and road users.
    • Pedestrian access will be maintained where possible, however some footpath closures may be required during specific stages of the works.

    Victoria Park Access & Parking

    During periods when works are occurring in Section B: Mill Street to King Street, access to Victoria Park will be maintained via the King Street entrance. Residents and visitors are asked to follow all temporary traffic signage and directions from traffic controllers.

    During the Section B works no on-street parking will be permitted along the frontage of Victoria Park. Users are requested to park within Victoria Park and access via the King Street entrance.

    Thank you

    Council appreciates the patience and understanding of residents, businesses and visitors while these important improvements are undertaken. These works will enhance the safety, accessibility and appearance of High Street for the benefit of the community.

    Streetscape and road improvement works will be undertaken along High Street, Koroit between Horne Street and Commercial Road. This stage of the project has been divided into three construction sections to minimise disruption and allow works to be completed efficiently.

    Construction Sections

    Works are scheduled to occur in October and November 2026, subject to weather conditions and contractor availability, between 7am to 6pm Monday to Friday, with the possibility of some weekend work. Estimated construction dates for each section are:

    Section A: Horne Street to Mill Street - 5 October to 6 November 2026
    Section B: Mill Street to King Street - 5 October to 6 November 2026
    Section C: King Street to Commercial Road - 19 October to 27 November 2026

    Important Information for Residents and Businesses

    During construction working hours, the following traffic and access arrangements will apply:

    • Sections of High Street will be closed to through traffic while roadworks are being undertaken, with detour routes to be signposted.
    • Access for local residents, businesses, deliveries and emergency services will be maintained wherever practical.
    • On-street parking will not be permitted within active work zones during construction activities.
    • Traffic management, detours and reduced speed limits will be in place to ensure the safety of workers and road users.
    • Pedestrian access will be maintained where possible, however some footpath closures may be required during specific stages of the works.

    Victoria Park Access & Parking

    During periods when works are occurring in Section B: Mill Street to King Street, access to Victoria Park will be maintained via the King Street entrance. Residents and visitors are asked to follow all temporary traffic signage and directions from traffic controllers.

    During the Section B works no on-street parking will be permitted along the frontage of Victoria Park. Users are requested to park within Victoria Park and access via the King Street entrance.

    Thank you

    Council appreciates the patience and understanding of residents, businesses and visitors while these important improvements are undertaken. These works will enhance the safety, accessibility and appearance of High Street for the benefit of the community.

  • Works update 7 September 2026

    Share Works update 7 September 2026 on Facebook Share Works update 7 September 2026 on X (formerly Twitter) Share Works update 7 September 2026 on Linkedin Email Works update 7 September 2026 link

    New bus stop locations

    Following the outcome of a community survey, Council will install 2 new bus stops along High Street: outside the Victoria Park entrance on the west side, and outside 78 High Street on the east as shown in this image. Construction will commence upon final approval from the Department of Transport for these locations.

    Landscaping

    Planting of trees and landscaping works has commenced.

    Streetscape works

    Our planned works in High Street for September may require some traffic management. We will confirm any road closures prior to works commencing.

    7-11 September

    • Mill Street to King Street, east side,
    • Kerb and channel construction
    • No planned road closure

    14-18 September

    • King Street to Council depot, east side
    • Kerb and channel construction
    • No planned road closure

    14-25 September

    • Council depot
    • Construction of kerb and car park
    • No planned road closure

    14-25 September

    • Horne Street to Mill Street
    • Road pavement construction
    • Full road closure, with detour in place via Wright Street, McVicar Street and Mill Street
    • Road will be open to traffic outside working hours

    28 September to 2 October

    • Horne Street to Mill Street
    • Road sealing works
    • Road closure in place

    New bus stop locations

    Following the outcome of a community survey, Council will install 2 new bus stops along High Street: outside the Victoria Park entrance on the west side, and outside 78 High Street on the east as shown in this image. Construction will commence upon final approval from the Department of Transport for these locations.

    Landscaping

    Planting of trees and landscaping works has commenced.

    Streetscape works

    Our planned works in High Street for September may require some traffic management. We will confirm any road closures prior to works commencing.

    7-11 September

    • Mill Street to King Street, east side,
    • Kerb and channel construction
    • No planned road closure

    14-18 September

    • King Street to Council depot, east side
    • Kerb and channel construction
    • No planned road closure

    14-25 September

    • Council depot
    • Construction of kerb and car park
    • No planned road closure

    14-25 September

    • Horne Street to Mill Street
    • Road pavement construction
    • Full road closure, with detour in place via Wright Street, McVicar Street and Mill Street
    • Road will be open to traffic outside working hours

    28 September to 2 October

    • Horne Street to Mill Street
    • Road sealing works
    • Road closure in place
  • Works update 3 July 2026

    Share Works update 3 July 2026 on Facebook Share Works update 3 July 2026 on X (formerly Twitter) Share Works update 3 July 2026 on Linkedin Email Works update 3 July 2026 link

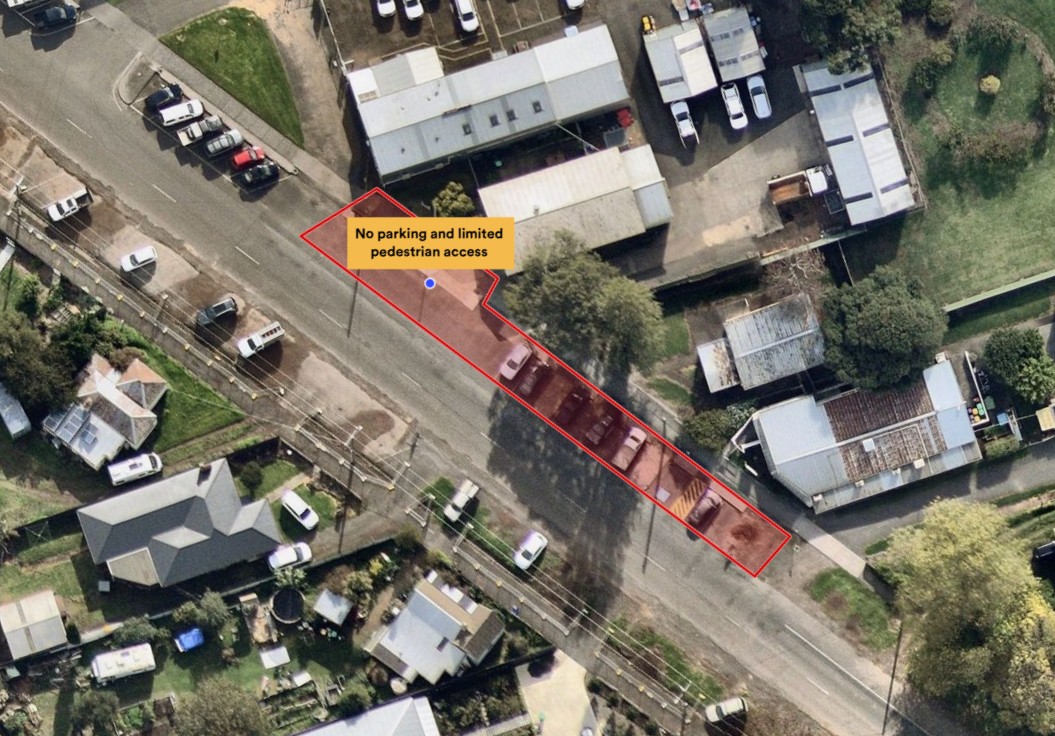

    From Monday 3 August to Wednesday 12 August 2026, works will take place along High Street, Koroit from the Council Depot to the Lions Club Op Shop.

    No parking will be available in this zone during the works, so please park on the western side of High Street or further along the eastern side.

    Security fencing and signage will be in place, however modified pedestrian and customer access will be maintained to the Op Shop

    Please follow all signage.

    For any questions or further information, contact our Project Management Office on 1300 656 564 or pmo@moyne.vic.gov.au

    From Monday 3 August to Wednesday 12 August 2026, works will take place along High Street, Koroit from the Council Depot to the Lions Club Op Shop.

    No parking will be available in this zone during the works, so please park on the western side of High Street or further along the eastern side.

    Security fencing and signage will be in place, however modified pedestrian and customer access will be maintained to the Op Shop

    Please follow all signage.

    For any questions or further information, contact our Project Management Office on 1300 656 564 or pmo@moyne.vic.gov.au

  • Improving access to public transport in Koroit

    Share Improving access to public transport in Koroit on Facebook Share Improving access to public transport in Koroit on X (formerly Twitter) Share Improving access to public transport in Koroit on Linkedin Email Improving access to public transport in Koroit link

    Moyne Shire Council is seeking community feedback on proposed new bus stop locations along High Street, Koroit. The proposal aims to improve access to public transport services for residents and visitors across the township.

    Why are new bus stops being proposed?

    Additional bus stops on High Street have been identified through several of Council’s planning and community engagement processes, including:

    • Community consultation undertaken as part of the Koroit Streetscape Project

    • Moyne Shire Council's Active Transport Plan (August 2025).

    • The Koroit Structure Plan 2020, which identified a need to improve bus stop infrastructure and public transport access.

    • Currently, there are only two bus stops servicing the southern end of High Street, located approximately 1 kilometre from key destinations.

    Funding

    The installation of the proposed bus stops will be fully funded by the Victorian Government through the Department of Transport and Planning.

    Proposed Options

    OPTION 1: 4 New Bus Stops (see map)

    Proposed locations:

    • Mickey Bourke's Hotel

    • Koroit Library

    • Botanic Gardens
    • Outside 64 High Street

    Benefits

    • 4 stops provide greater coverage across High Street.

    • Convenient access to the Post Office, Library and Senior Citizens Hall, and the east end of the Commercial Road area.

    • Located within 240 metres of Victoria Park.

    • Located within 100 metres of the Bowls and Croquet Clubs.

    • Improved access to the Caravan Park, Botanic Gardens, Kindergarten and Medical Clinic.

    Considerations

    • Approximately 4 on-street parking spaces would be removed in front of Mickeys Bourke's Hotel.

    OPTION 2: 2 New Bus Stops (see map)

    Proposed locations:

    • Victoria Park

    • Outside 78 High Street

    Benefits:

    • Direct access to Victoria Park.

    • Approximately 200 metres from the Bowls and Croquet Clubs.

    • Approximately 300 metres from the Caravan Park, Botanic Gardens, Kindergarten, Medical Clinic, Post Office, Library and Senior Citizens Hall.

    • No loss of existing on-street parking spaces.

    Considerations

    • Fewer bus stops.

    • Further distance to walk to most community facilities in High Street and Commercial Road.

    Bus Stop Design

    Regardless of the option selected, each bus stop will include:

    • New kerb works

    • Concrete boarding pads

    • Tactile ground surface indicators for accessibility

    • New bus stop signage

    (Based on Department of Transport Requirements)

    Timing

    Subject to approval, construction is planned to occur during August/September 2026.

    The survey closes 2 August 2026.

    Moyne Shire Council is seeking community feedback on proposed new bus stop locations along High Street, Koroit. The proposal aims to improve access to public transport services for residents and visitors across the township.

    Why are new bus stops being proposed?

    Additional bus stops on High Street have been identified through several of Council’s planning and community engagement processes, including:

    • Community consultation undertaken as part of the Koroit Streetscape Project

    • Moyne Shire Council's Active Transport Plan (August 2025).

    • The Koroit Structure Plan 2020, which identified a need to improve bus stop infrastructure and public transport access.

    • Currently, there are only two bus stops servicing the southern end of High Street, located approximately 1 kilometre from key destinations.

    Funding

    The installation of the proposed bus stops will be fully funded by the Victorian Government through the Department of Transport and Planning.

    Proposed Options

    OPTION 1: 4 New Bus Stops (see map)

    Proposed locations:

    • Mickey Bourke's Hotel

    • Koroit Library

    • Botanic Gardens
    • Outside 64 High Street

    Benefits

    • 4 stops provide greater coverage across High Street.

    • Convenient access to the Post Office, Library and Senior Citizens Hall, and the east end of the Commercial Road area.

    • Located within 240 metres of Victoria Park.

    • Located within 100 metres of the Bowls and Croquet Clubs.

    • Improved access to the Caravan Park, Botanic Gardens, Kindergarten and Medical Clinic.

    Considerations

    • Approximately 4 on-street parking spaces would be removed in front of Mickeys Bourke's Hotel.

    OPTION 2: 2 New Bus Stops (see map)

    Proposed locations:

    • Victoria Park

    • Outside 78 High Street

    Benefits:

    • Direct access to Victoria Park.

    • Approximately 200 metres from the Bowls and Croquet Clubs.

    • Approximately 300 metres from the Caravan Park, Botanic Gardens, Kindergarten, Medical Clinic, Post Office, Library and Senior Citizens Hall.

    • No loss of existing on-street parking spaces.

    Considerations

    • Fewer bus stops.

    • Further distance to walk to most community facilities in High Street and Commercial Road.

    Bus Stop Design

    Regardless of the option selected, each bus stop will include:

    • New kerb works

    • Concrete boarding pads

    • Tactile ground surface indicators for accessibility

    • New bus stop signage

    (Based on Department of Transport Requirements)

    Timing

    Subject to approval, construction is planned to occur during August/September 2026.

    The survey closes 2 August 2026.

  • Works update 2 July 2026

    Share Works update 2 July 2026 on Facebook Share Works update 2 July 2026 on X (formerly Twitter) Share Works update 2 July 2026 on Linkedin Email Works update 2 July 2026 link

    Footpath, kerb and channel, and other works are now underway along High Street, Koroit.

    • July-August – eastern side from Lions Op Shop to Commercial Road
    • July-August – western side from Sturt St to Commercial Road
    • Late July-August – western side from Garden Street to Bowls Club
    • Late July - September– eastern side from Mill Street to Council depot
    • August – Council depot car park (new visitor car parking & minor works)
    • August-October – new asphalt road surface, carparks, wombat crossing and bus stop completion (following community consultation), line marking, and landscaping including planting of new trees.

    The northbound lane on High Street will be closed daily from Sturt Street to Commercial Road from 8am to 5pm during works until 10 July.

    Please follow all detour signage, and drive to the conditions of the road.

    We appreciate the patience and cooperation of the Koroit community as we complete these essential works. Safety is our priority, and these temporary measures help ensure a safe environment for everyone.

    For any questions or further information, please contact our Project Management Office on 1300 656 564 or pmo@moyne.vic.gov.au

    Footpath, kerb and channel, and other works are now underway along High Street, Koroit.

    • July-August – eastern side from Lions Op Shop to Commercial Road
    • July-August – western side from Sturt St to Commercial Road
    • Late July-August – western side from Garden Street to Bowls Club
    • Late July - September– eastern side from Mill Street to Council depot
    • August – Council depot car park (new visitor car parking & minor works)
    • August-October – new asphalt road surface, carparks, wombat crossing and bus stop completion (following community consultation), line marking, and landscaping including planting of new trees.

    The northbound lane on High Street will be closed daily from Sturt Street to Commercial Road from 8am to 5pm during works until 10 July.

    Please follow all detour signage, and drive to the conditions of the road.

    We appreciate the patience and cooperation of the Koroit community as we complete these essential works. Safety is our priority, and these temporary measures help ensure a safe environment for everyone.

    For any questions or further information, please contact our Project Management Office on 1300 656 564 or pmo@moyne.vic.gov.au

  • Works update 12 June 2026

    Share Works update 12 June 2026 on Facebook Share Works update 12 June 2026 on X (formerly Twitter) Share Works update 12 June 2026 on Linkedin Email Works update 12 June 2026 link

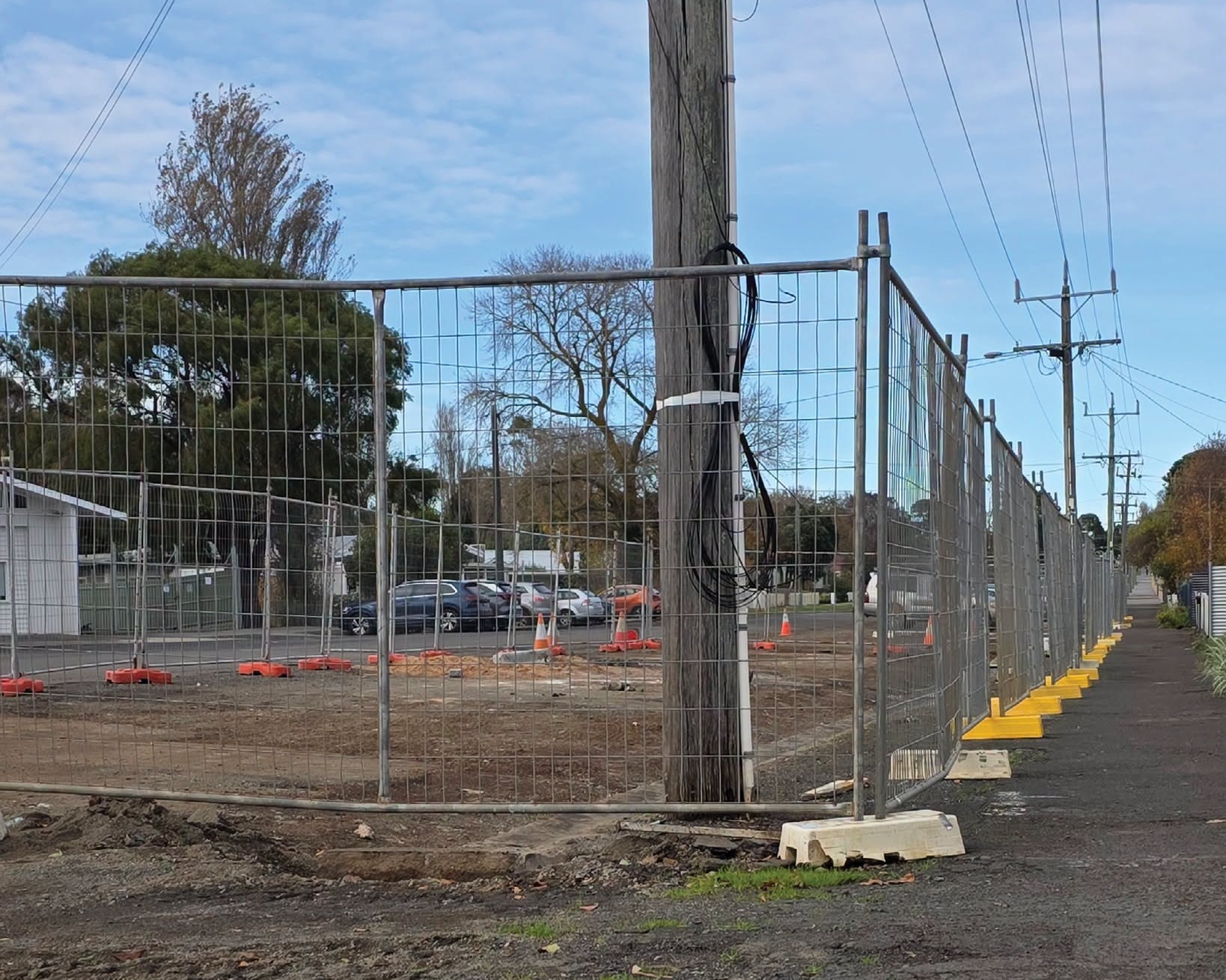

    supporting image

    Footpath renewal works on High Street will commence Wednesday 17 June 2026.

    These works will be underway on the western side of High Street until 1 July 2026 and may see minor interruptions to traffic during this time.

    Footpath renewal works on High Street will commence Wednesday 17 June 2026.

    These works will be underway on the western side of High Street until 1 July 2026 and may see minor interruptions to traffic during this time.

  • Works update 18 May 2026

    Share Works update 18 May 2026 on Facebook Share Works update 18 May 2026 on X (formerly Twitter) Share Works update 18 May 2026 on Linkedin Email Works update 18 May 2026 link

    On-street parking will not be available on the western side of High Street, Koroit for approximately 1 week commencing Wednesday 20 May 2026, due to essential drainage and kerb construction works.

    These restrictions will be in place between King Street and Sturt Street. During this time, we kindly ask residents and visitors to make alternative parking arrangements.

    Following this stage, rolling construction works will continue along the street, including:
    - Footpath upgrades
    - Driveway reinstatements
    - Road renewal works

    As these works progress, there will be intermittent impacts to on-street parking and property access. Every effort will be made to maintain access wherever possible, and advance notice will be provided where temporary restrictions are required.

    We understand these disruptions may cause inconvenience and sincerely appreciate your patience and cooperation while these important improvements are carried out.

    If you have any questions or require assistance during the works, please contact us on 1300 656 564.

    On-street parking will not be available on the western side of High Street, Koroit for approximately 1 week commencing Wednesday 20 May 2026, due to essential drainage and kerb construction works.

    These restrictions will be in place between King Street and Sturt Street. During this time, we kindly ask residents and visitors to make alternative parking arrangements.

    Following this stage, rolling construction works will continue along the street, including:
    - Footpath upgrades
    - Driveway reinstatements
    - Road renewal works

    As these works progress, there will be intermittent impacts to on-street parking and property access. Every effort will be made to maintain access wherever possible, and advance notice will be provided where temporary restrictions are required.

    We understand these disruptions may cause inconvenience and sincerely appreciate your patience and cooperation while these important improvements are carried out.

    If you have any questions or require assistance during the works, please contact us on 1300 656 564.

  • Works update 27 April 2026

    Share Works update 27 April 2026 on Facebook Share Works update 27 April 2026 on X (formerly Twitter) Share Works update 27 April 2026 on Linkedin Email Works update 27 April 2026 link
    Streetscape works in Koroit have now temporarily stopped in advance of the Koroit Irish Festival.

    Works completed to date on Commercial Road include new bluestone paving, street furniture, a drinking fountain and asphalt treatments across the sections from Mickey Bourke's corner to the Chemist, and from the Theatre corner to the Koroit Newsagency.

    Works along High Street have progressed well, and will also be paused for the festival.

    Council sincerely thanks local residents, business owners and the broader community for your continued cooperation, patience and flexibility throughout the construction period. Your support has been greatly appreciated and has contributed to the successful delivery of these important public realm improvements.

    Works will resume from 11 May 2026.

    Streetscape works in Koroit have now temporarily stopped in advance of the Koroit Irish Festival.

    Works completed to date on Commercial Road include new bluestone paving, street furniture, a drinking fountain and asphalt treatments across the sections from Mickey Bourke's corner to the Chemist, and from the Theatre corner to the Koroit Newsagency.

    Works along High Street have progressed well, and will also be paused for the festival.

    Council sincerely thanks local residents, business owners and the broader community for your continued cooperation, patience and flexibility throughout the construction period. Your support has been greatly appreciated and has contributed to the successful delivery of these important public realm improvements.

    Works will resume from 11 May 2026.

  • Works update 3 February 2026

    Share Works update 3 February 2026 on Facebook Share Works update 3 February 2026 on X (formerly Twitter) Share Works update 3 February 2026 on Linkedin Email Works update 3 February 2026 link

    The main part of the Koroit Township Renewal project will be commencing from early February 2026. Following the summer shut down period for Council and trades, Council’s project team have met with current contractors for High Street and Commercial Road works to develop and agree a co-ordinated project plan for this major stage of the project. This meeting discussed the expectations of Council in relation to time, budget, quality, safety, works, and community management.

    To help ensure efficient delivery of this major project, Council have appointed a dedicated project team to oversee and manage contractors, works and ongoing communications.

    High Street
    Footpath and kerb channel works will commence in High Street Monday 9 February 2026 from Horne Street on the Botanic Gardens side (western side).

    Footpath, kerb and channel works have been broken into 8 stages on both sides of High Street to ensure impacts on residences, pedestrians, traffic, Victoria Park, Caravan Park, Bowls Club, emergency services, medical clinic, kindergarten and depot operations are minimised wherever possible across the life of the project.

    Works planning forecast that footpath, kerb and channel, mains water relocation and reconnection, Telstra pit works and drainage works will take around 7 months to complete with an anticipated completion date for these works by the end of August.

    Others works in High Street include road renewal, carparks, 4 new bus stops, new school wombat crossing, tree planting and general landscaping and line marking. An integrated all of project plan will be finalised within the next week or so and be available from Council’s project page on Engage Moyne or through the Project Management Office.

    Commercial Road
    Footpath and ancillary works in Commercial Road are expected to re-start from next week from the Koroit Vets to the Pharmacy and then relocate to the Koroit Theatre (Commercial Place and Commercial Road) to ensure this area is completed prior to the Irish Festival at the end of April.

    Council certainly understands that there will be some disruptions at times to traffic and pedestrian access to properties and businesses. Vehicle and footpath conditions are subject to change, and all traffic and pedestrians are required to follow traffic controller directions and directional signage. Until road renewal works occur later on in the year, it is planned that there will be ongoing traffic access along High Street.

    Project updates will be provided through letters, community noticeboards, social media and this project page on Engage Moyne. see the map of the proposed stages of works for High Street below.

    Council acknowledged the community’s patience and understanding as these important infrastructure upgrades are undertaken.

    If you have any concerns, issues or questions, please contact the Project Management Office via email – pmo@moyne.vic.gvo.au or alternatively, call Council customer service on 1300 65 65 64.

    The main part of the Koroit Township Renewal project will be commencing from early February 2026. Following the summer shut down period for Council and trades, Council’s project team have met with current contractors for High Street and Commercial Road works to develop and agree a co-ordinated project plan for this major stage of the project. This meeting discussed the expectations of Council in relation to time, budget, quality, safety, works, and community management.

    To help ensure efficient delivery of this major project, Council have appointed a dedicated project team to oversee and manage contractors, works and ongoing communications.

    High Street
    Footpath and kerb channel works will commence in High Street Monday 9 February 2026 from Horne Street on the Botanic Gardens side (western side).

    Footpath, kerb and channel works have been broken into 8 stages on both sides of High Street to ensure impacts on residences, pedestrians, traffic, Victoria Park, Caravan Park, Bowls Club, emergency services, medical clinic, kindergarten and depot operations are minimised wherever possible across the life of the project.

    Works planning forecast that footpath, kerb and channel, mains water relocation and reconnection, Telstra pit works and drainage works will take around 7 months to complete with an anticipated completion date for these works by the end of August.

    Others works in High Street include road renewal, carparks, 4 new bus stops, new school wombat crossing, tree planting and general landscaping and line marking. An integrated all of project plan will be finalised within the next week or so and be available from Council’s project page on Engage Moyne or through the Project Management Office.

    Commercial Road
    Footpath and ancillary works in Commercial Road are expected to re-start from next week from the Koroit Vets to the Pharmacy and then relocate to the Koroit Theatre (Commercial Place and Commercial Road) to ensure this area is completed prior to the Irish Festival at the end of April.

    Council certainly understands that there will be some disruptions at times to traffic and pedestrian access to properties and businesses. Vehicle and footpath conditions are subject to change, and all traffic and pedestrians are required to follow traffic controller directions and directional signage. Until road renewal works occur later on in the year, it is planned that there will be ongoing traffic access along High Street.

    Project updates will be provided through letters, community noticeboards, social media and this project page on Engage Moyne. see the map of the proposed stages of works for High Street below.

    Council acknowledged the community’s patience and understanding as these important infrastructure upgrades are undertaken.

    If you have any concerns, issues or questions, please contact the Project Management Office via email – pmo@moyne.vic.gvo.au or alternatively, call Council customer service on 1300 65 65 64.

  • Commercial Road works update

    Share Commercial Road works update on Facebook Share Commercial Road works update on X (formerly Twitter) Share Commercial Road works update on Linkedin Email Commercial Road works update link

    Works on the new bluestone paving in the area of Mickey Bourke's on the corner of Commercial Road and High Street, Koroit are progressing well. With paving works nearly completed on the main intersection corner, pedestrian crossing points at High Street, Woolsthorpe Road and Commercial Road are expected to be open from this Friday morning. Pedestrians and vehicles are required to following any traffic directions and controls.

    Paving works will be completed up to the veterinary clinic for the summer and Christmas season and recommence in late January / early February from the Laundromat to the Eatery and then shift to the Koroit Theatre.

    Works on the new bluestone paving in the area of Mickey Bourke's on the corner of Commercial Road and High Street, Koroit are progressing well. With paving works nearly completed on the main intersection corner, pedestrian crossing points at High Street, Woolsthorpe Road and Commercial Road are expected to be open from this Friday morning. Pedestrians and vehicles are required to following any traffic directions and controls.

    Paving works will be completed up to the veterinary clinic for the summer and Christmas season and recommence in late January / early February from the Laundromat to the Eatery and then shift to the Koroit Theatre.

Page last updated: 06 Nov 2026, 07:57 PM
